CRM Standardization Across Portfolio Companies: What to Decide and How to Judge It

CRM Standardization Across Portfolio Companies: What to Decide and How to Judge It

You have four platform companies in the fund. Between them, they run three CRM systems, two of which nobody trusts, and a fourth company that keeps its pipeline in a shared spreadsheet the sales director guards like a family recipe. Your operating partner wants a single revenue picture across the portfolio. The CFO wants forecast reliability she can put in front of the board. And the sales leaders at each company are quietly convinced that any change to “their” system is a threat aimed at them personally.

This is the moment where CRM standardization across portfolio companies stops being an IT topic and becomes a value-creation decision. It affects forecast accuracy, cross-portfolio commercial reporting, the speed at which you can integrate an add-on, and, eventually, the quality of the revenue story you tell a buyer at exit. Get it wrong and you burn a year of budget on a migration that damages pipeline discipline. Get the sequencing right and you get clean revenue data, faster onboarding of new acquisitions, and a management team that can actually see what is happening.

This guide is written for the operating partner or portfolio executive who already holds the budget and the mandate. It skips the definitions and gets to the decisions you actually own: what to standardize, what to leave alone, how to sequence it, and how to judge whether it worked.

1. Start with the commercial reason, not the platform

The first mistake is framing this as “which CRM should we all use.” That question invites a religious war between HubSpot loyalists and Salesforce loyalists and produces a decision that satisfies procurement and nobody else. The better opening question is: what commercial outcome are we buying with standardization, and for whom?

There are only a handful of legitimate answers, and they lead to different scopes:

  • Portfolio-level revenue visibility. The fund wants comparable pipeline and bookings data across companies so the operating team can spot which businesses are converting and which are stalling. This needs standardized definitions and reporting, not necessarily a single platform.
  • Forecast reliability. The CFO and the board need a forecast that holds. This is mostly a process and hygiene problem that a CRM can support but cannot solve on its own.
  • Faster add-on integration. A buy-and-build thesis where you will bolt on 5 to 15 companies over the hold. Here a standard platform and a repeatable onboarding playbook has real, compounding value.
  • Cost consolidation. Fewer licenses, fewer admins, fewer integrations. Real but usually the smallest prize, and a poor primary justification on its own.

Bain’s annual work on private equity value creation, tracked in its Global Private Equity Report, has repeatedly made the point that operational improvement, not multiple arbitrage, carries more of the return burden than it used to. Revenue systems sit squarely inside that operational lever. But the lever only pays if you connect the standardization work to one of the outcomes above and refuse to let it drift into a generic “modernize our tech stack” project with no owner accountable for a number.

Write down the primary outcome before you touch the platform question. If you cannot name the commercial reason in one sentence that a deal partner would nod at, you are not ready to spend the money.

2. Decide the standardization tier, because “one CRM” is rarely the answer

Standardization is not binary. The instinct to force every company onto one instance of one platform is usually the most expensive path and often the wrong one. There are four tiers, and different portfolios sit at different points depending on thesis and diversity of the businesses.

Tier 1: Standardized reporting only

Companies keep their own CRMs. You standardize the definitions (what counts as a qualified opportunity, what stages mean, how bookings are recorded) and pipe the data into a common reporting layer. Cheapest, fastest, least disruptive. Good when the businesses are genuinely different (different sales motions, different products) and you mainly want comparable visibility.

Tier 2: Standardized platform, separate instances

Every company runs the same CRM (say, all on one vendor), but each has its own configured instance. You get shared skills, shared vendor leverage, portable admins, and a repeatable onboarding template, without forcing unrelated businesses to share a database.

Tier 3: Standardized platform and shared configuration

Same platform, same core configuration and data model, deployed per company. Now add-ons onboard fast because the target maps to a known blueprint. Strong fit for buy-and-build platforms in one vertical.

Tier 4: Single shared instance

All companies in one CRM instance, one database. Rarely appropriate across distinct portfolio companies, and it raises data-segregation, ownership and eventual carve-out problems that will bite you at exit. Usually reserved for tightly integrated operating companies, not a diversified fund.

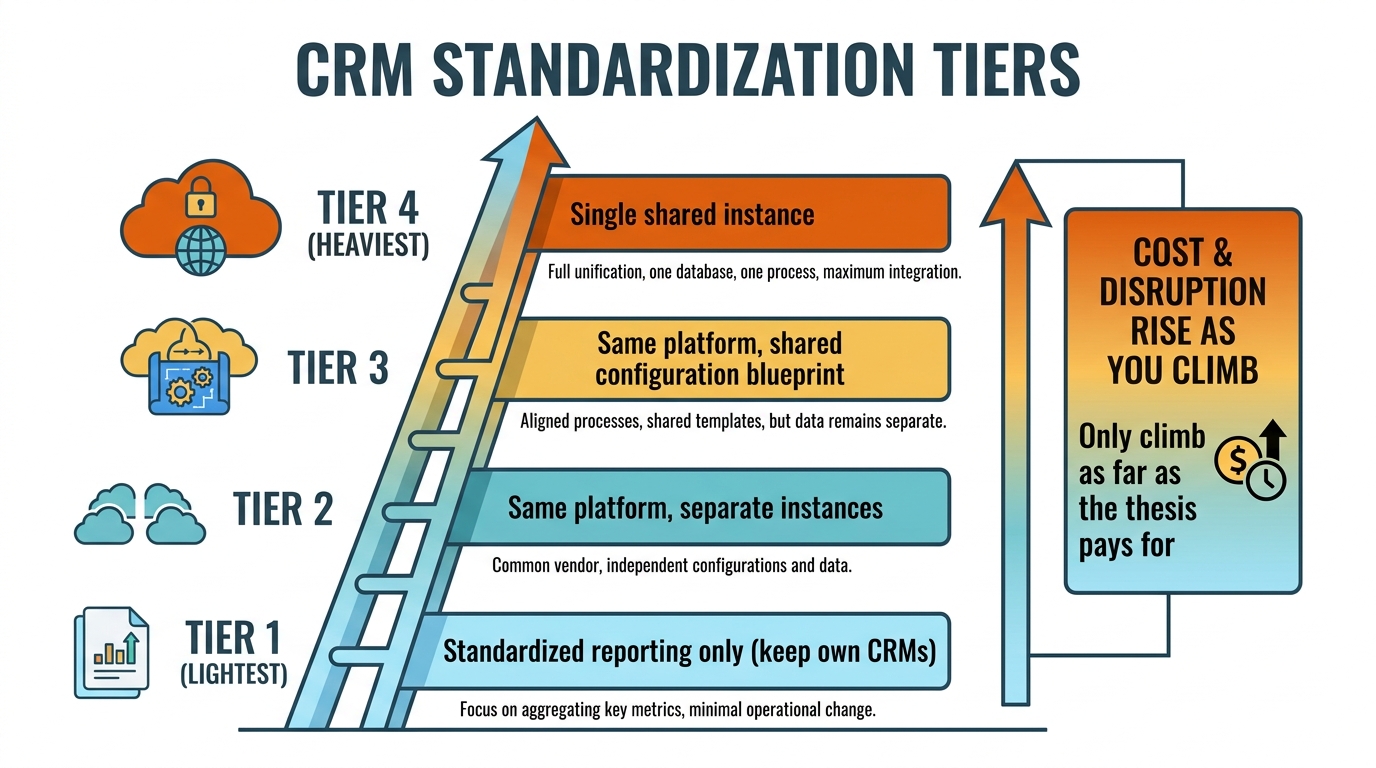

CRM Standardization Tiers | 4-tier ladder from lightest to heaviest, Tier 1: Standardized reporting only (keep own CRMs)

The judgment call is: climb only as high as your commercial reason justifies. A visibility problem is solved at Tier 1. A buy-and-build integration thesis usually justifies Tier 3. Almost nobody needs Tier 4 across a real portfolio.

2. How to read the current state before you commit budget

Before you pick a tier or a platform, you need an honest baseline of what each company actually runs and how much of it is real. This is diligence work, and if you are pre-close it belongs alongside your technology due diligence rather than as an afterthought in the first board meeting.

For each company, get evidence, not the sales director’s opinion, on:

  • System of record. What is the actual CRM, and what percentage of live deals live in it versus in spreadsheets, inboxes, or someone’s head. A CRM with 40% adoption is not a CRM, it is a reporting fiction.
  • Data quality. Duplicate rate, stale open opportunities, missing close dates, blank owners. This is the real cost driver of any migration.
  • Process discipline. Are stages defined and enforced, or is “proposal sent” whatever the rep says it is. Forecast reliability lives here, not in the tool.
  • Integrations. What the CRM feeds (billing, finance, marketing, support) and what breaks if it moves.
  • Contracts. License terms, renewal dates, and any lock-ins that change the timing math.

Producing this baseline usually takes a focused two to three weeks per company. The output is a simple grid: system, adoption, data quality, process maturity, integration dependencies, contract exposure. That grid tells you which companies are close to ready, which need process remediation before any migration, and which should be left alone entirely for now.

3. Separate the platform decision from the process decision

The single most common failure I see operating teams make is treating standardization as a software rollout. You buy the licenses, run a migration project, declare victory, and six months later the forecast is no better because the underlying sales process was never fixed. The tool changed. The behavior did not.

There are two distinct workstreams and they have different owners:

  • The process and definitions workstream. Common stage definitions, a common qualification standard, a common way to record bookings and forecast categories. This is owned by revenue operations and the sales leadership, and it is the workstream that actually moves forecast reliability. It can start before any platform decision and often should.
  • The platform and data workstream. Configuration, migration, integration, reporting layer. This is owned by RevOps and IT together, with a named accountable person per company.

You can standardize definitions and reporting (the value driver) while leaving multiple platforms in place for a while. What you cannot do is standardize a platform on top of undisciplined processes and expect the platform to impose discipline for you. It will not. Fix the process definitions first, then the platform work has something clean to land on.

4. Choose the platform, but weight the right criteria

Assume you have decided Tier 2 or Tier 3, so a single platform is on the table. The vendor choice matters less than the criteria you weight, because most operating teams over-index on feature checklists and under-index on the things that actually determine whether the standardization holds.

Weight these heavily

  • Fit to the dominant sales motion across the portfolio. A portfolio of transactional, high-volume businesses has different needs than one of complex enterprise sales. Pick for the majority motion, not the loudest sales director.
  • Repeatability of deployment. How fast can you stand up a new instance for an add-on. This is where a buy-and-build thesis earns its money.
  • Admin availability and cost. A platform nobody in your talent market can administer is a liability, not a standard.
  • Portability at exit. Whatever you build, a future buyer or a carve-out will need to extract it cleanly. Design for that now.

Weight these lightly

  • Long feature comparison matrices. Nearly all serious platforms do the core job. The differentiators on the sheet rarely survive contact with actual adoption.
  • AI feature marketing. Useful later, irrelevant to the standardization decision. Do not let it drive the choice.

If you are running a formal selection, this is also the moment to be honest about the advisor you bring in. The checklist in what private equity should ask a RevOps consultant is worth reading before you sign anyone, because the difference between a consultant who ships adoption and one who ships a configuration document is the whole game.

5. Sequence the rollout so you protect pipeline while you change it

The risk that keeps operating partners up at night is not that the migration fails technically. It is that you disrupt live selling during the migration and lose a quarter of pipeline momentum you never recover. Sequencing is how you manage that risk.

A sane order of operations across a portfolio:

Step 1: Standardize definitions across all companies first

Get every company reporting against common stage and forecast definitions in whatever system they currently run. This is low-disruption and immediately improves cross-portfolio visibility. It also surfaces which companies have real process problems, which changes your migration priority.

Step 2: Build the blueprint on your healthiest company

Deploy the standard platform and configuration on the company with the cleanest data and the most cooperative sales leadership. Use it as the reference implementation. Do not start with your messiest company, you will confuse “the standard is wrong” with “this company was already broken.”

Step 3: Remediate data before you migrate, never during

Clean, dedupe, and archive dead opportunities in the source system before the cutover. Migrating dirty data into a clean platform just relocates the mess and destroys trust in the new system on day one.

Step 4: Roll to remaining companies against the blueprint

Now each subsequent company is a repeat of a known pattern, not a new project. Speed increases, cost per company drops, and the playbook gets sharper each time.

Step 5: Cut over on quarter boundaries, not mid-quarter

Migrate at the start of a selling period so reps have a full quarter in the new system and you are not reconciling two systems mid-forecast.

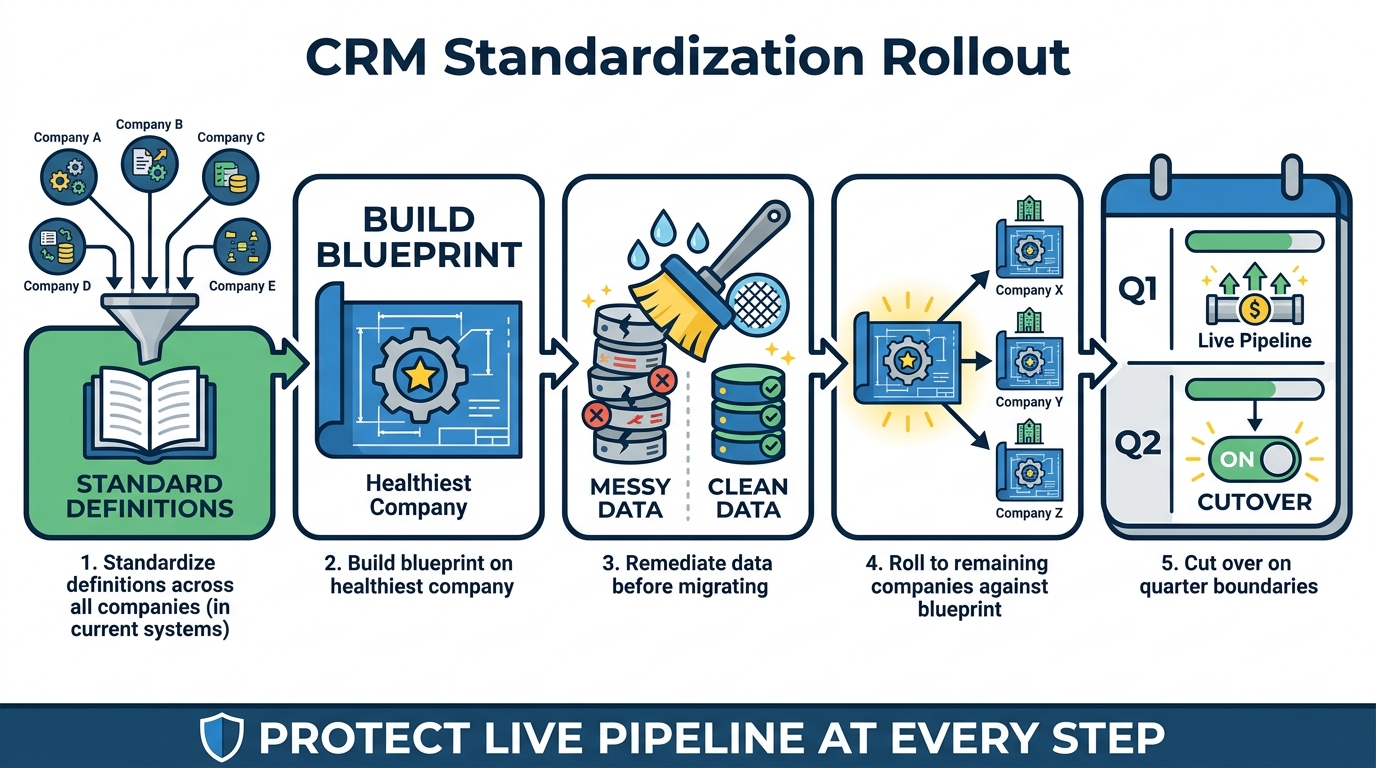

CRM Standardization Rollout Sequence | 5 steps left to right, 1. Standardize definitions across all companies (in curren

6. Get the Day 1 and first 100 days version right for add-ons

Standardization is not only a portfolio-wide program you run once. For a buy-and-build platform, every add-on is a fresh instance of the same problem, and the value of your blueprint is precisely that it turns a bespoke project into a playbook. The first 100 days after an add-on closes is where you either onboard the new company onto the standard cleanly or let it become a fifth exception you will be apologizing for at exit.

The repeatable add-on onboarding sequence should already exist before you close the deal:

  • Baseline the target’s CRM and data quality during confirmatory diligence, not after.
  • Decide at signing whether the target migrates to the standard, keeps its system through a transition period, or reports into the standard layer immediately.
  • Assign a named integration owner from the platform company, not the fund.
  • Set a migration date tied to a quarter boundary in the integration plan.

This is exactly the discipline that separates funds that scale a buy-and-build cleanly from funds that accumulate integration debt. As the analysis of how longer hold periods move the value creation burden to the operator lays out, the operator who owns the hold now owns the integration quality too, and CRM onboarding is one of the most visible tests of whether that discipline exists.

7. Handle carve-outs and separation cases differently

Not every company in your portfolio is a permanent tenant. Some will be sold, some spun out, and if you bought a division out of a larger parent, its CRM may still be entangled with systems you do not own. Standardization decisions have to account for the exit shape.

Two situations deserve special care:

  • Carve-outs still running on parent systems. A division carved out of a corporate parent often has no clean CRM of its own, just an entitlement to use the parent’s during a transition services period. Standing up a proper standalone CRM is frequently one of the first real value-creation moves. The dynamics of turning orphaned divisions into standalone value apply directly here, and the CRM is one of the systems that makes “standalone” real.
  • Companies you may sell separately. If a company might be divested before the fund exit, do not fold it into a shared instance you will then have to painfully untangle. Keep it at Tier 2 (own instance) so it can be sold with its own clean data.

The general rule: never build a standardization pattern that a future buyer would have to reverse. Portability at separation should be a design constraint from the start, not a problem you discover in the data room.

8. Instrument the outcome, so you can prove it worked

Every standardization program should be judged on evidence, and the evidence has to be defined before you start, not reverse-engineered after. If you cannot state the baseline and the target, you are running an activity, not a value-creation project.

The metrics worth committing to:

Adoption

Percentage of live deals recorded in the system of record, and percentage of reps updating it within a defined window. Below roughly 90% adoption, most other numbers are unreliable. This is the leading indicator of whether the standard actually took.

Forecast reliability

Actual bookings versus forecast, measured at the start of each period and compared to close. This is the number the CFO cares about and the one that shows up in board reporting. Tightening the gap between forecast and actual is the clearest financial proof the work paid off.

Cross-portfolio comparability

Can you produce one report showing pipeline, conversion, and bookings across all companies on common definitions, without a two-week manual reconciliation. If yes, the visibility outcome is real.

Add-on onboarding time

Days from close to the new company reporting on the standard. For a buy-and-build, this should fall with each acquisition. If it is not falling, the blueprint is not actually repeatable.

How to Judge CRM Standardization | table with columns "Metric | Baseline | Target | Owner" and rows: CRM adoption (% dea

McKinsey’s work on private capital and operations and BCG’s research on value creation in principal investing both keep returning to the same point: the funds that consistently improve operations are the ones that instrument and manage against defined targets rather than declaring initiatives complete when the software is installed. Treat this program the same way.

9. Budget, timeline, and where the money actually goes

Executives approving this work usually underestimate two things and overestimate one. They underestimate the data remediation and change-management effort. They underestimate the process definition work. And they overestimate the platform licensing as a share of total cost.

A realistic distribution of effort on a multi-company standardization program:

  • Discovery and baseline. Two to three weeks per company, front-loaded.
  • Process and definition standardization. Often the highest-value, most under-resourced workstream. Runs partly in parallel with everything else.
  • Configuration and migration. The visible project, but rarely the largest cost.
  • Data remediation. Consistently the most underestimated line. Budget for it explicitly per company.
  • Adoption and enablement. Training, incentive alignment, manager reinforcement. Skip this and adoption collapses within a quarter.

Timeline-wise, standardizing reporting definitions across a portfolio can show value in a quarter. A full platform standardization across four to six companies is more realistically a 9 to 18 month program depending on data quality and the number of live migrations. Trying to compress that into a single quarter is the fastest way to disrupt pipeline and lose the sales teams. The Harvard Law School Forum on Corporate Governance regularly publishes practitioner work on post-acquisition operational programs that makes the same case: sequencing and change management, not tooling, determine whether these programs deliver.

10. The decision checklist

Before you approve budget for CRM standardization across portfolio companies, you should be able to answer each of these clearly. If you cannot, you have more preparation to do.

  • Commercial reason. Can you state in one sentence the outcome you are buying (visibility, forecast reliability, add-on integration, or cost) and who benefits.
  • Tier. Have you chosen the standardization tier that matches the reason, rather than defaulting to a single shared instance.
  • Baseline. Do you have evidence-based current-state grids for each company covering adoption, data quality, process maturity, integrations, and contracts.
  • Process first. Have you separated the definitions workstream from the platform workstream, with the definitions work starting first.
  • Owner. Is there a single named accountable owner per company and one program owner overall, with real decision rights.
  • Sequence. Do you have a rollout order that starts with your healthiest company and protects live pipeline at cutover.
  • Add-on playbook. Does a repeatable onboarding sequence exist for future acquisitions.
  • Exit design. Have you avoided any pattern a future buyer or carve-out would have to reverse.
  • Metrics. Are baselines and targets defined for adoption, forecast reliability, comparability, and onboarding time before the work starts.
  • Budget honesty. Have you explicitly funded data remediation and adoption, not just licenses and configuration.

11. Where this sits in the broader value-creation plan

CRM standardization is one lever inside a larger revenue and go-to-market program, and it is worth keeping it in proportion. It supports forecast reliability, cross-portfolio visibility, and faster integration. It does not, by itself, generate demand or fix a broken sales motion. Treat it as the plumbing that lets the rest of the RevOps work be measured, not as the thing that grows the business.

For funds thinking about how these operational levers connect to returns, the reading on how entry pricing shifts where returns have to come from is relevant: when you pay a full multiple at entry, more of the return has to come from operational improvement over the hold, and clean revenue data is what lets you manage that improvement instead of guessing at it. Sources like PitchBook and S&P Global Market Intelligence that track deal and operating trends keep pointing to the same reality: the margin for lazy operations has narrowed, and revenue systems that produce trustworthy numb
