Examples of Risk Assessment in Process Changes

Most process changes fail when teams skip risk review before rollout. In these examples, I see the same pattern each time: define the change, score the risks, assign owners, set rollback points, and check results after launch.

Here’s the short version:

  • Manufacturing change: A packaging company found that an old inspection step was slowing output from 235 meters per minute to 100 meters per minute. After reviewing the risk, it moved checks upstream, cut labor needs by 50%, and saved $29,010.40 right away plus $87,031.20 per year.
  • Software change: An ERP rollout team mapped people, process, and data risks before go-live. Each risk had an owner, a score, and a rollback trigger. That helped the company keep work moving during cutover.
  • Policy and org change: A global manufacturer used ISO 31000 to fix weak ownership, approvals, and communication. Within six months, it hit 100% compliance and later cut incidents and supply-chain disruptions by 30%.

What do these cases show me?

  • Old controls can add cost without lowering risk
  • Named ownership keeps issues from drifting
  • Rollback criteria matter when a launch starts to slip
  • Risk scoring should change as rollout data changes

Modern Change Launch & Learn Session 3 – Dynamic Risk

Quick Comparison

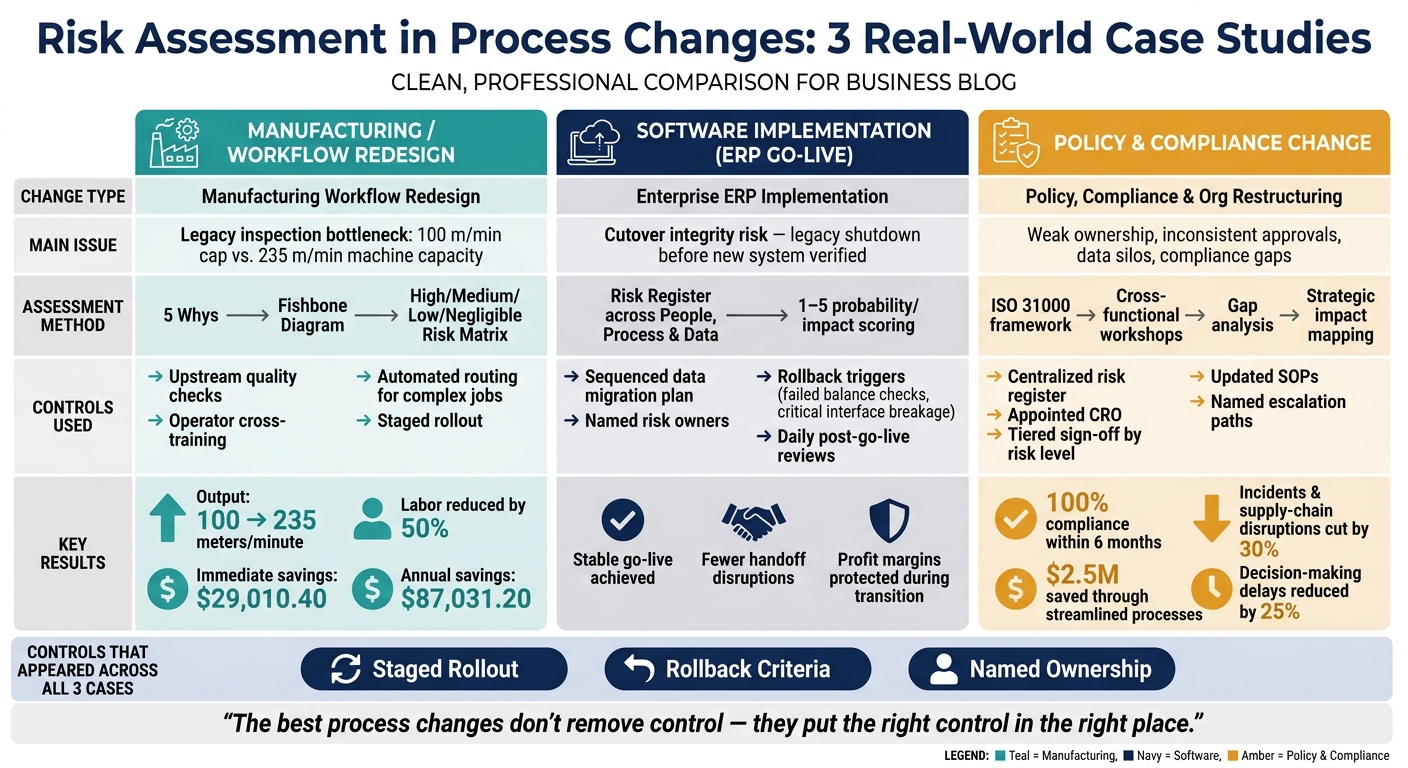

Risk Assessment in Process Changes: 3 Real-World Case Studies Compared

Risk Assessment in Process Changes: 3 Real-World Case Studies Compared

Change type Main issue found Controls used Result
Manufacturing/workflow Legacy inspection bottleneck Upstream checks, cross-training, staged routing Output moved from 100 to 235 meters/minute
Software implementation Cutover failure risk Risk register, migration plan, rollback triggers, daily reviews Stable go-live with fewer handoff issues
Policy/compliance Weak ownership and approval flow Central register, clear decision rights, tiered sign-off 100% compliance in six months

If I had to boil the article down to one point, it would be this: the best process changes do not remove control – they put the right control in the right place.

Case Study 1: Manufacturing Workflow Redesign

In January 2026, a mid-sized packaging manufacturer redesigned its Wide Web Finish department. The main problem wasn’t a quality failure. It was an old control that slowed the whole line down without lowering risk. The seaming machine could run at 235 meters per minute, but downstream inspection held output to 100 meters per minute.

Risks Identified Before the Change

Before making changes, the team used 5 Whys and Fishbone diagrams to test whether the 100% downstream inspection still had a clear quality purpose. It didn’t. They confirmed that this step was a legacy control, not a true quality requirement. They also flagged the inspection point as a source of high labor variance.

Risk Matrix and Staged Rollout Controls

After the team pinned the issue to the control itself, it matched the rollout plan to the level of risk. Using a High/Medium/Low/Negligible matrix, the group focused its review on the steps with the most risk exposure. It then made three key moves:

  • Shifted final quality checks to the seamer
  • Cross-trained operators
  • Sent only complex jobs to downstream inspection through automated routing

That matters because the team didn’t just remove a checkpoint and hope for the best. It kept control where it still made sense and cut it where it no longer did.

Results After Implementation

After the bottleneck was removed, the line ran at the seamer’s full 235 meters per minute instead of 100. The redesign cut labor needs by half. It also produced $29,010.40 in immediate savings and $87,031.20 in annualized savings.

This gets to the heart of process risk assessment: remove controls that no longer reduce risk.

Case Study 2: Enterprise Software Implementation

ERP and CRM rollouts hit people, process, and data at the same time. That’s what makes them tricky. If a cutover goes wrong, work can stall across the business. In software projects like this, the main risk isn’t throughput. It’s cutover integrity.

Building a Risk Register Across People, Process, and Data

In May 2026, a cybersecurity services company getting ready for ERP go-live flagged a cutover risk: the legacy system might be shut down before the new system was fully checked, which could create a backlog if transactions stopped moving.

To get ahead of that, the team kept a risk register across three areas. It covered people risks, like training gaps and role confusion; process risks, like duplicate work and integration failures; and data risks, like migration errors and field-mapping mismatches. Each risk had:

  • An owner
  • A probability score
  • An impact rating
  • A rollback trigger

The team scored each item on a 1–5 scale.

Once those risks were laid out, the team put controls around the failure points that could do the most damage.

Mitigation Steps Before and During Go-Live

The company, led by Altum Strategy, treated go-live as an execution phase, not the end of the project. It put together a sequenced data migration plan, assigned clear handoffs, and ran daily post-go-live support with daily issue reviews.

The cutover checklist also spelled out clear rollback criteria, including failed balance checks or critical interface breakage. If either happened, the team could return to the pre-cutover state instead of pushing ahead with a bad launch.

Adoption and Continuity Outcomes

The cybersecurity company stabilized operations fast and protected profit margins during the transition window. The end result was a stable go-live with fewer disruptions during the handoff period.

Case Study 3: Policy, Compliance, and Organizational Change

Policy updates and team restructuring often hit at the same time during organizational change. That mix can create serious rollout risk. If approval workflows change while reporting lines shift, teams can miss key tasks when ownership isn’t spelled out.

In February 2025, a global manufacturing firm used ISO 31000 to bring its uneven risk processes into one shared system across production, finance, and IT. Cross-functional workshops and a gap analysis brought several weak spots into the open: inconsistent documentation, missed approvals, data silos, and compliance gaps tied to applicable regulations.

Before implementation, the company defined decision rights and escalation paths. That step made it much easier to see where execution could break down. In practice, the main risk points came down to ownership, approval, and communication.

Controls Used to Reduce Execution Risk

Once the risks were mapped, the company shifted from assessment into governance controls.

It appointed a CRO and centralized its risk register, with each risk tied to an owner, score, and escalation path. It also updated its Standard Operating Procedures to set clearer communication lines and documentation standards. Leaders then tiered the change by risk level, so the highest-risk items faced the strictest review and sign-off requirements.

This matters because policy change can look tidy on paper but get messy fast in execution. A new workflow means little if no one knows who has final approval or when an issue needs to move up the chain.

What Improved After the Change

The results came fast. Within six months, the company reached 100% compliance. In the first year, it cut incidents and supply-chain disruptions by 30%, saved $2.5 million through streamlined processes, and reduced decision-making delays by 25%.

Cross-Case Lessons and Conclusion

Across the manufacturing, software, and policy examples, the same pattern showed up again and again: each team set the scope, scored risks before launch, assigned clear owners, and updated the assessment as things changed. That leads to a practical question for any SME: which method fits this change?

Which Assessment Methods Fit Which Type of Change

The best tool depends on the kind of change in front of you.

A compliance overhaul usually needs a compliance gap analysis plus a regulatory risk assessment. A software rollout tends to work better with a risk dashboard or a risk-scored backlog backed by live system data, so teams deal with the highest-risk components first. And a workflow redesign calls for impact and dependency mapping to show the scope of impact, including how many teams and process steps the change could touch.

Initial risk scores should be treated as a starting point, not a final answer. As implementation data shifts, the scores should shift too.

The summary below pairs each change type with the assessment method and control set that fit best.

Change Type Main Risks Assessment Method Mitigation Controls
Manufacturing / Workflow Resource gaps, technical feasibility, execution quality Inherent Risk Assessment & Tiering Staged rollout, capacity planning, owner assignment
Software Implementation Technical complexity, scope of impact, change density Risk Dashboard & Live System Data Prioritized backlog (high-risk first), rollback criteria
Policy & Compliance Regulatory exposure, control gaps, cultural resistance Strategic Context & Impact Mapping Named ownership, feedback loops, board oversight

For SMEs, the right choice comes down to what the team needs most: risk prioritization, ownership tracking, or failure-mode testing.

Key Points for Business Owners

Risk assessment works best before rollout starts, not after the first issue hits. Early identification, whether through gap analysis, impact mapping, or live system data, tends to lead to better results than reactive fixes in the middle of implementation.

Ownership matters just as much. Every risk on the register needs a named person who is responsible for monitoring it and escalating it when needed. Without that, even a well-scored risk matrix can turn into a document that just sits there.

As Julien Haye of Aevitium LTD put it: "Not all change is – or should be – growth-oriented. Initiatives focused on simplification, automation, or incident reduction often have the highest ROI on resilience."

In each case, teams stayed on track because they updated the assessment during rollout instead of waiting for failure. Three controls appeared across all cases:

  • Staged rollout
  • Rollback criteria
  • Named ownership

Those controls helped keep each project moving as conditions shifted during implementation.

FAQs

How do I choose the right risk assessment method for my change?

Start by defining the scope of the change and spotting risks across people, processes, technology, and organizational factors. Then review each risk based on likelihood and impact so you can see what needs attention first.

For high-impact changes, use a more detailed method. For smaller, lower-risk changes, keep it lighter. The method should fit your organization’s readiness, dependencies, risk appetite, and the complexity of the change.

What should trigger a rollback during implementation?

A rollback should happen when high-impact risks found during risk assessment or ongoing monitoring start to play out and put the change effort at risk.

That can include things like employee resistance, process disruptions, or technology failures.

When those issues move from a warning sign to an actual threat, it’s time to step back before the change causes more damage.

Who should own risks during a process change?

Risk ownership during a process change should sit with a team that brings different functions together. In most cases, that means people from engineering, operations, maintenance, and EHS.

That mix matters. Engineering may spot design issues, operations can flag day-to-day process concerns, maintenance often sees equipment weak points, and EHS helps identify safety and compliance risks. Working together, they review possible hazards and deal with them before the change goes live.
